How Long Does Home Interior Work Take in Bangalore? Timeline from Design to Handover

Table of Contents

You collected the keys in March. The designer promised “about two months”. Now it is June, the sofa is still wrapped in plastic, and the carpenter has not turned up for a week.

Delays like this are common, and mostly avoidable. Knowing the real timeline before you sign anything puts you back in control.

So, how long does home interior take in Bangalore? Here is the honest, phase-by-phase answer.

How Long Does Home Interior Take? The Short Answer

For a full turnkey project, plan on 6 to 12 weeks, depending on the size and scope of your home.

  • Design and material sign-off: about 2 to 3 weeks
  • On-site installation: our 45-day installation timeline
  • Final checks and handover: built into the end of the project

Smaller scopes sit towards the shorter end. Larger homes, or projects with heavy civil work, sit towards the longer end. We agree the schedule with you upfront, with clear milestones.

A sample journey (illustrative)

  • Weeks 1 to 3: consultation, 3D designs and material sign-off
  • Weeks 4 to 10: manufacturing and our 45-day installation window
  • Final days: quality checks and a complete handover walkthrough

Your own plan will vary with home size, scope and how quickly decisions are made.

Home Interior Timeline Bangalore: Phase by Phase

Use this home interior timeline Bangalore as a planning guide. Phases overlap in a well-run project. Manufacturing, for example, begins while civil work is still under way.

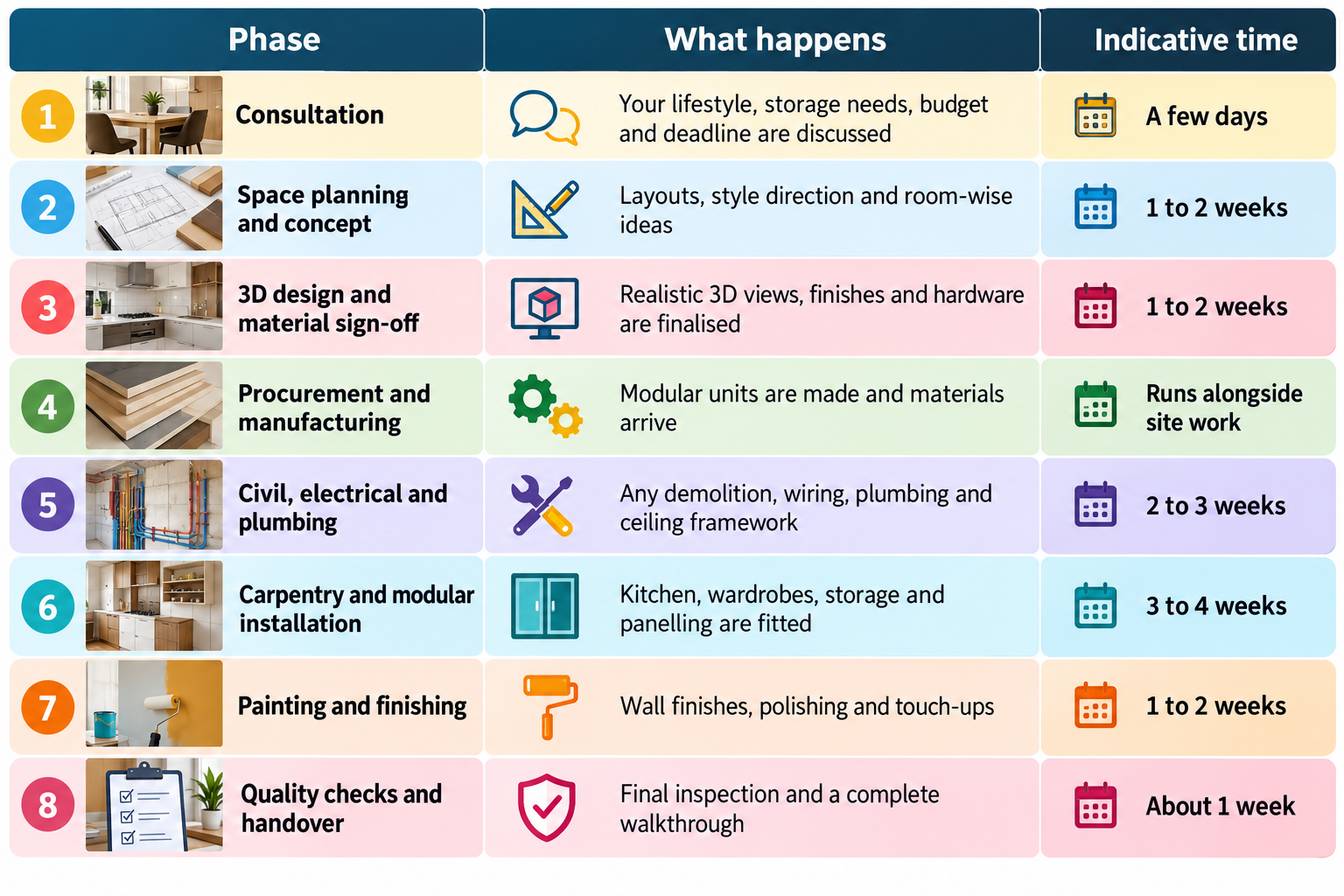

C:\Users\Nithin A\OneDrive - MedVoice Inc\MedVoice Support's files - MARKETING\All Blogs Tracker\My Insta Spaces Blog topic & content updates\Blog\Yet To Post\long does home\table 1.png

Indicative ranges for planning. Your exact schedule depends on scope and site readiness.

The design stage matters most

The first 2 to 3 weeks decide how smoothly the rest goes. Every change you make after 3D approval can mean re-ordering material and re-planning work.

How Long Does Home Interior Work Take in Bangalore?
  • Review the 3D views room by room.
  • Confirm finishes, handles and hardware in writing.
  • Settle your appliance models early, as they decide cabinet sizes.

The build stage moves fast when it is planned

Once materials are signed off and the site is ready, the build runs to a fixed plan.

The build stage moves fast when it is planned
  • Civil, electrical and plumbing come first.
  • Carpentry and modular units follow, then ceiling and painting.
  • Regular project tracking updates keep you informed, wherever you live.

What Is a 45-Day Interior?

A 45-day interior refers to our 45-day installation timeline. It covers the on-site build-out once your design, materials and site are ready.

Here is what that means in practice:

  • The clock starts after 3D designs and materials are approved.
  • The site should be accessible and free of pending builder snags.
  • Late design changes can shift the schedule, and we tell you early if they do.

This is why we do not promise “ready in 30 days” for a full home. A realistic schedule is one you can trust.

For Bangalore homes, three local habits help:

  • Book the society’s material lift and working-hour slots in advance.
  • Keep a small buffer if your start date falls in festive weeks or heavy rain.
  • Share your possession date early, so design and manufacturing can run ahead of the keys.

Curious how your home would work out? Get a free cost estimate and talk to a designer about your timeline.

What Slows Interior Work Down in Bangalore?

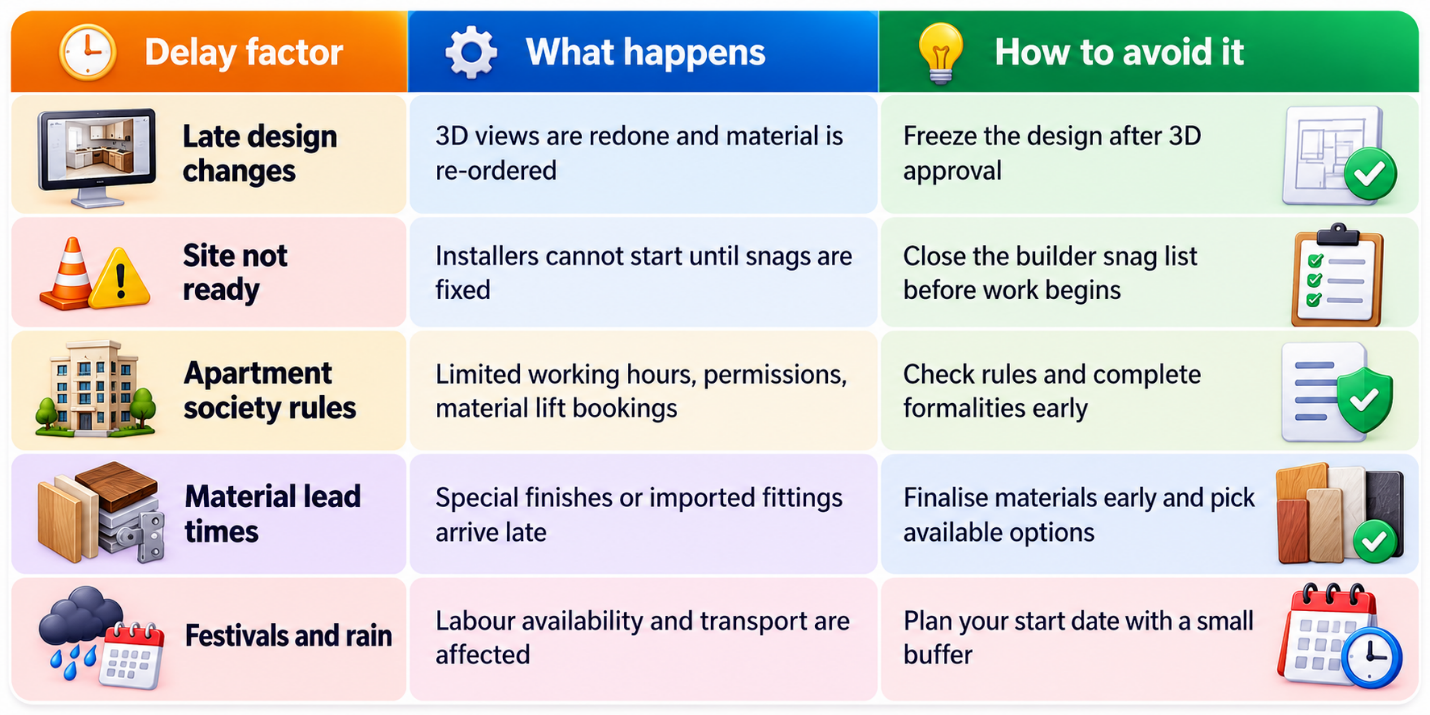

C:\Users\Nithin A\OneDrive - MedVoice Inc\MedVoice Support's files - MARKETING\All Blogs Tracker\My Insta Spaces Blog topic & content updates\Blog\Yet To Post\long does home\table 2.png

Many apartment communities in areas like Whitefield, Sarjapur Road and HSR Layout set renovation rules. Checking them first saves days.

6 Ways to Keep Your Project on Time

  • Start design before possession. Layouts, 3D views and material choices can be finalised while you wait for the keys.
  • Decide once. Fix finishes and fittings at the 3D stage.
  • Choose appliances early. Chimney, hob and refrigerator sizes shape the kitchen.
  • Clear permissions. Sort society approvals before the team arrives.
  • Avoid peak festive weeks. Labour is stretched around Dussehra and Diwali.
  • Pick one accountable team. Fewer handovers between vendors mean fewer gaps.

Why Plan Your Timeline with My Insta Spaces

Coordinating many vendors is the biggest cause of delay. With one turnkey team, design, manufacturing, installation and finishing run as a single plan.

  • 3D visuals before manufacturing begins
  • 146 quality checks during production
  • Regular project tracking updates throughout
  • Branded materials and a flat 10-year warranty
  • India’s first and only on-site service warranty
Why Plan Your Timeline with My Insta Spaces

Ready to Plan Your Home Interior Timeline?

Share your handover date and we will map a schedule that works. Book a free consultation or explore our turnkey interiors. You can also call +91 97414 24332 or write to co*****@***********es.com.

Frequently Asked Questions

How long does home interior take for a 2BHK or 3BHK in Bangalore?

A full turnkey project typically takes 6 to 12 weeks, depending on size and scope. Smaller scopes sit towards the shorter end, and larger homes or heavy civil work towards the longer end.

What is the 45-day interior timeline?

It is our 45-day installation timeline for the on-site build-out. It begins once designs, materials and site readiness are confirmed.

Can interior design start before I get possession?

Yes. Layouts, 3D views and material selection can be finalised beforehand, so installation starts sooner after handover of the keys.

Do monsoon and festivals delay interior work?

They can. Rain affects transport, and festive weeks reduce labour availability. A small buffer in your start date helps.

What happens if I change the design midway?

Changes after 3D approval can mean re-ordering material and re-planning work, which may extend the schedule. We flag the impact early.
